255 St (Twp Rd 530A) Water Line Extension

Share 255 St (Twp Rd 530A) Water Line Extension on Facebook Share 255 St (Twp Rd 530A) Water Line Extension on X (formerly Twitter) Share 255 St (Twp Rd 530A) Water Line Extension on Linkedin Email 255 St (Twp Rd 530A) Water Line Extension link

Project Description:

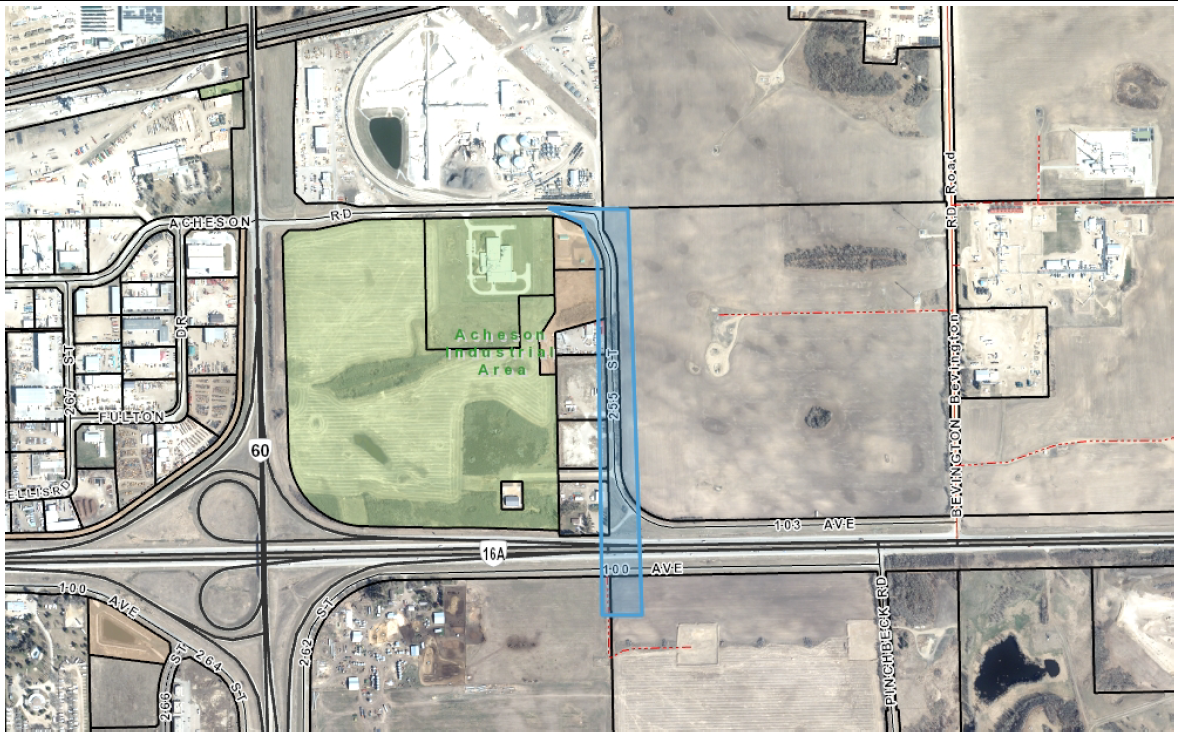

Construction of Water Line Extension along 255 St (Township Rd 530A)


**255 St is closed under a staged road closure until November 8, 2025. See Road closure phase and detour plan below**




Scope of Work:

Installation of approximately 1,000 m of water line via Horizontal Directional Drilling under Hwy 16A and open cut installation along 255 St.




Schedule:

Est. Start date: August 25, 2025

Est. Completion Date: November 15, 2025

Schedule can change without notice, follow page for monthly updates.




Project Co-ordinator:

Contractor (Primary Contact): CKB Construction, Project Manager – Jason Stiksma,

780-453-6611, jstiksma@ckbconstruction.com

Consultant (Secondary Contact)CIMA+, Site Inspector – Ethan Li, 780-297-2462, ethan.li@cima.ca

Parkland Project Manager: Franco Giammarioli, 780-968-8888 ext.8390,

franco.giammarioli@parklandcounty.com




Updates:

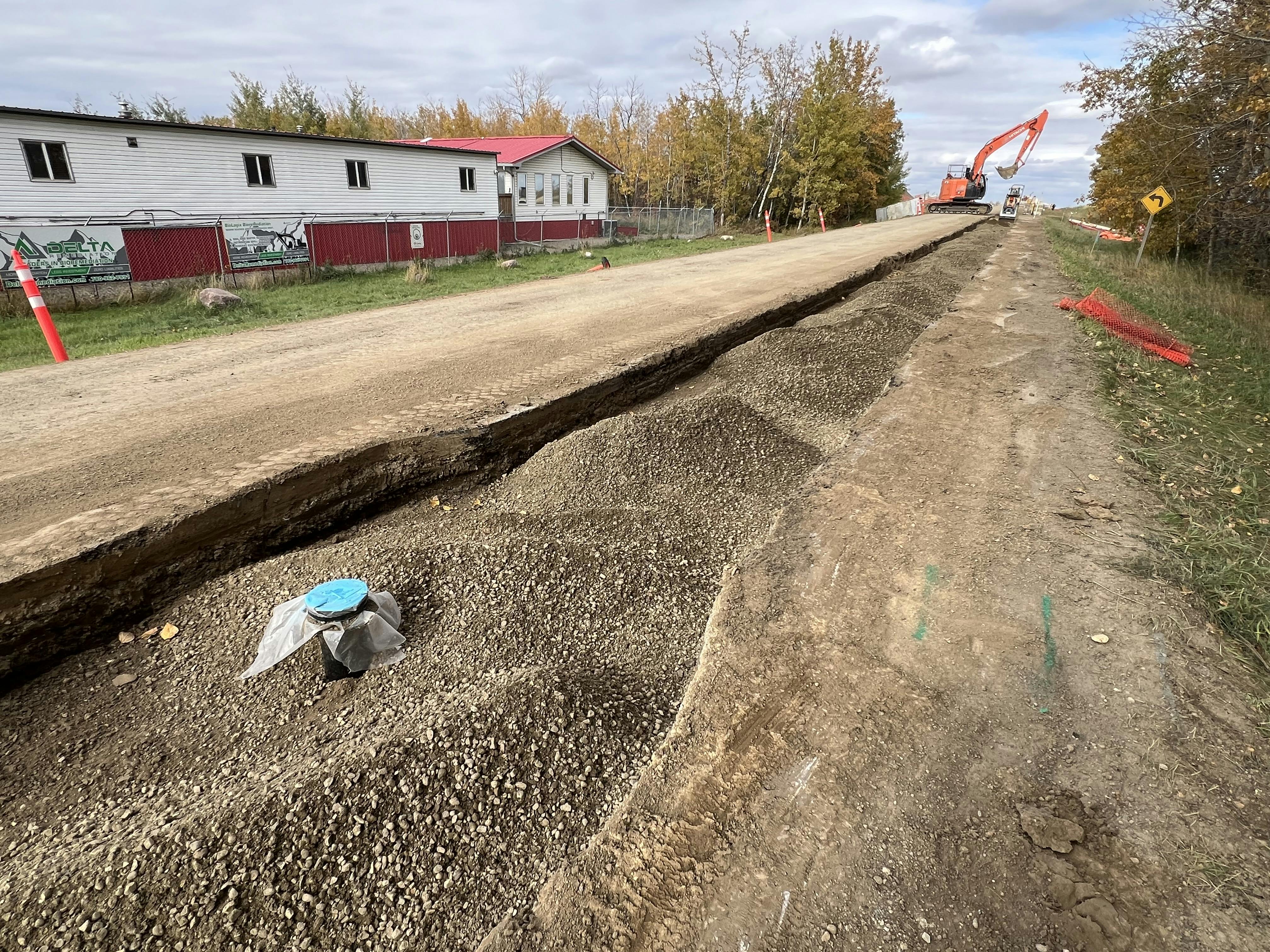

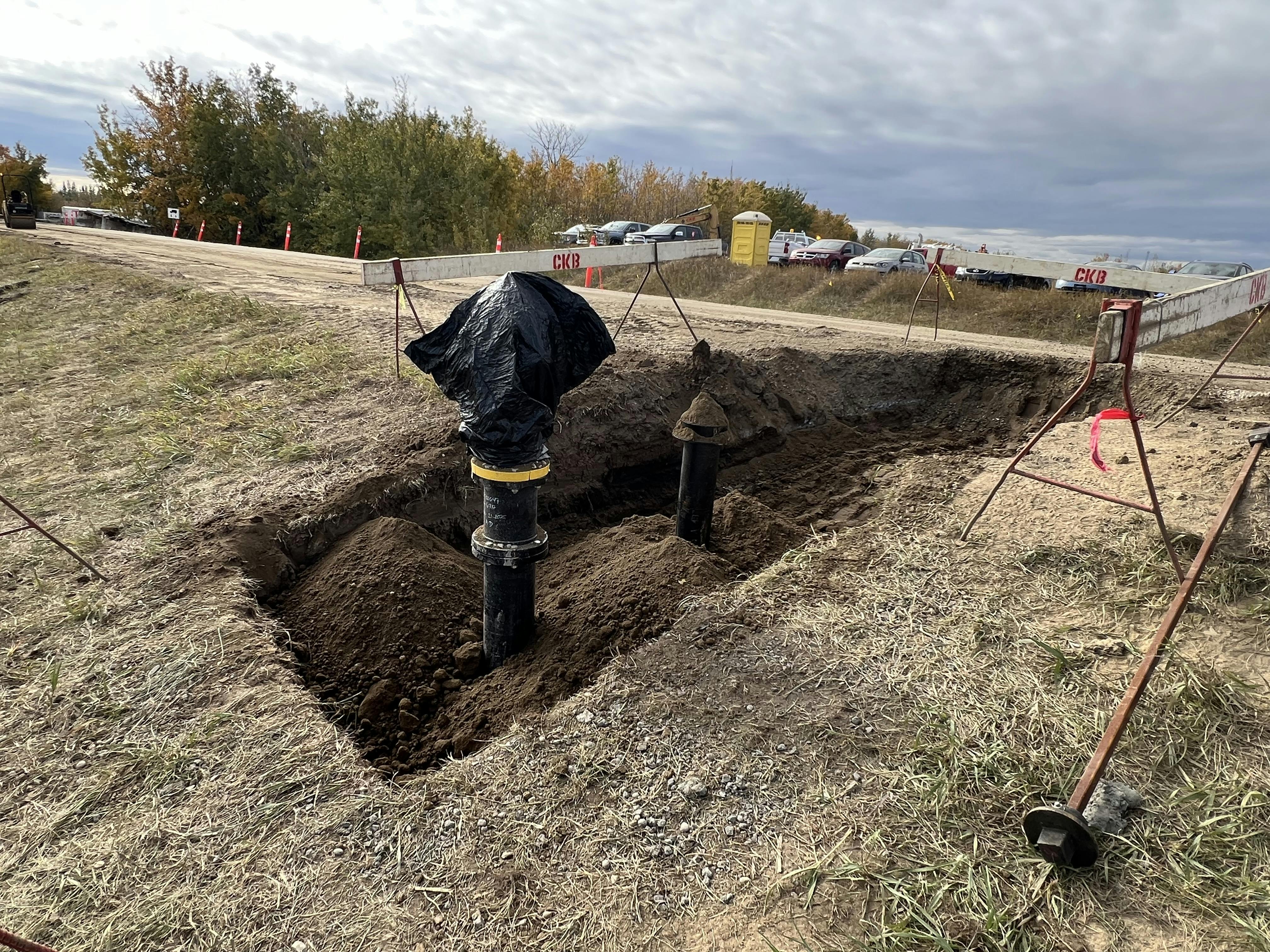

October 10, 2025: The 255 St project has now shifted to the Phase 2 road closure (see photos). Open trench water line and hydrant installations are ongoing along 255 St.

September 26, 2025: 255 St is closed under the Phase 1 road closure (see below). Horizontal directional drilling of the waterline across Hwy 16A is complete and open trench water line installations are ongoing along 255 St.

August 25, 2025: CKB Construction is set to begin mobilization for the 255 St Water Line Extension project. Single lane alternative traffic accommodations will be in place on 255 St.



Staged Detour:

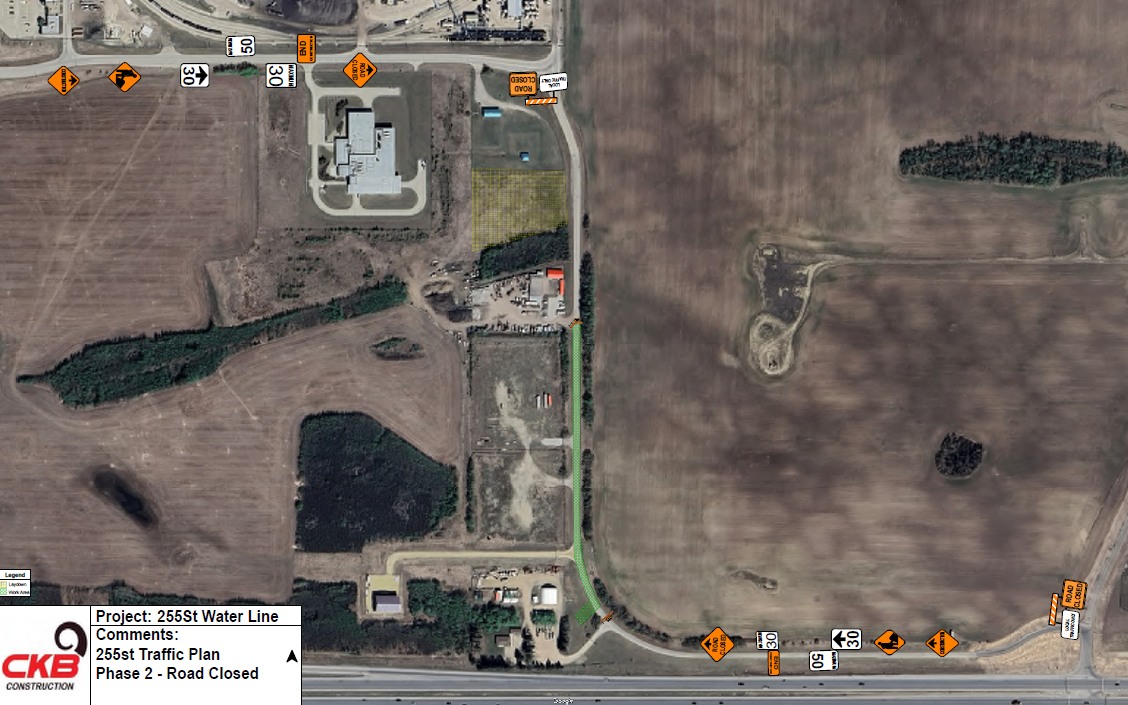

Phase 2 road closure


Location:


Project Description:

Construction of Water Line Extension along 255 St (Township Rd 530A)


**255 St is closed under a staged road closure until November 8, 2025. See Road closure phase and detour plan below**




Scope of Work:

Installation of approximately 1,000 m of water line via Horizontal Directional Drilling under Hwy 16A and open cut installation along 255 St.




Schedule:

Est. Start date: August 25, 2025

Est. Completion Date: November 15, 2025

Schedule can change without notice, follow page for monthly updates.




Project Co-ordinator:

Contractor (Primary Contact): CKB Construction, Project Manager – Jason Stiksma,

780-453-6611, jstiksma@ckbconstruction.com

Consultant (Secondary Contact)CIMA+, Site Inspector – Ethan Li, 780-297-2462, ethan.li@cima.ca

Parkland Project Manager: Franco Giammarioli, 780-968-8888 ext.8390,

franco.giammarioli@parklandcounty.com




Updates:

October 10, 2025: The 255 St project has now shifted to the Phase 2 road closure (see photos). Open trench water line and hydrant installations are ongoing along 255 St.

September 26, 2025: 255 St is closed under the Phase 1 road closure (see below). Horizontal directional drilling of the waterline across Hwy 16A is complete and open trench water line installations are ongoing along 255 St.

August 25, 2025: CKB Construction is set to begin mobilization for the 255 St Water Line Extension project. Single lane alternative traffic accommodations will be in place on 255 St.



Staged Detour:

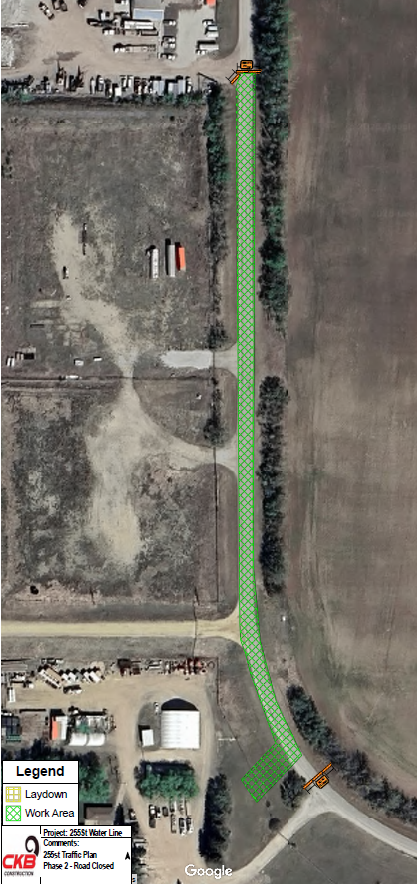

Phase 2 road closure


Location:
