Wabamun Lagoon Rehabilitation

Share Wabamun Lagoon Rehabilitation on Facebook Share Wabamun Lagoon Rehabilitation on Twitter Share Wabamun Lagoon Rehabilitation on Linkedin Email Wabamun Lagoon Rehabilitation link

Project Description:

Berm repairs and replacement of manholes and valves at the Wabamun Lagoon


Scope of Work:

Replacement of lagoon inlet manhole, control structure between facultative cell and storage cell A, and replacement of valves at Wabamun Lagoon. Berm repair was completed in 2024, only clean-up work remaining.


Schedule:

Est. Start date: May 21, 2025 – July 1, 2025

Schedule can change without notice, follow page for monthly updates.


Project Co-ordinator:

Contractor (Primary Contact): Jason Stiksma, CKB Construction, Jstiksma@ckbconstruction.com

Consultant (Secondary Contact): Greg Germain, ISL Engineering, ggermain@islengineering.com

Parkland Project Officer: Ryan McCaffrey, 780-217-9196, ryan.mccaffrey@parklandcounty.com


Updates:

October 1, 2025 – Project Complete. All deficiencies addressed and work will be monitored throughout the remainder of the warranty period.

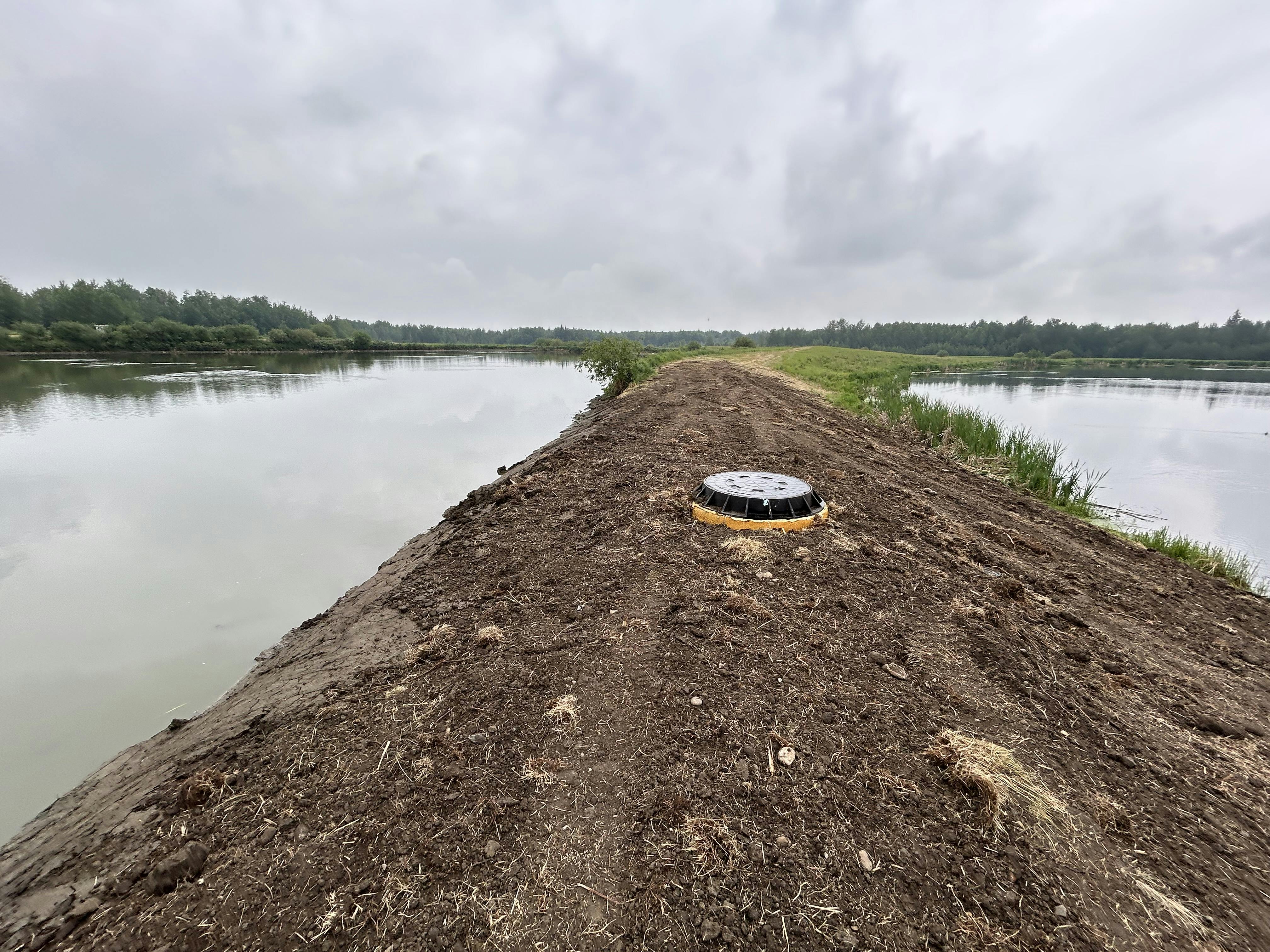

June 18, 2025 – All construction and final walkthrough completed. Warranty now in effect until June 18, 2027.

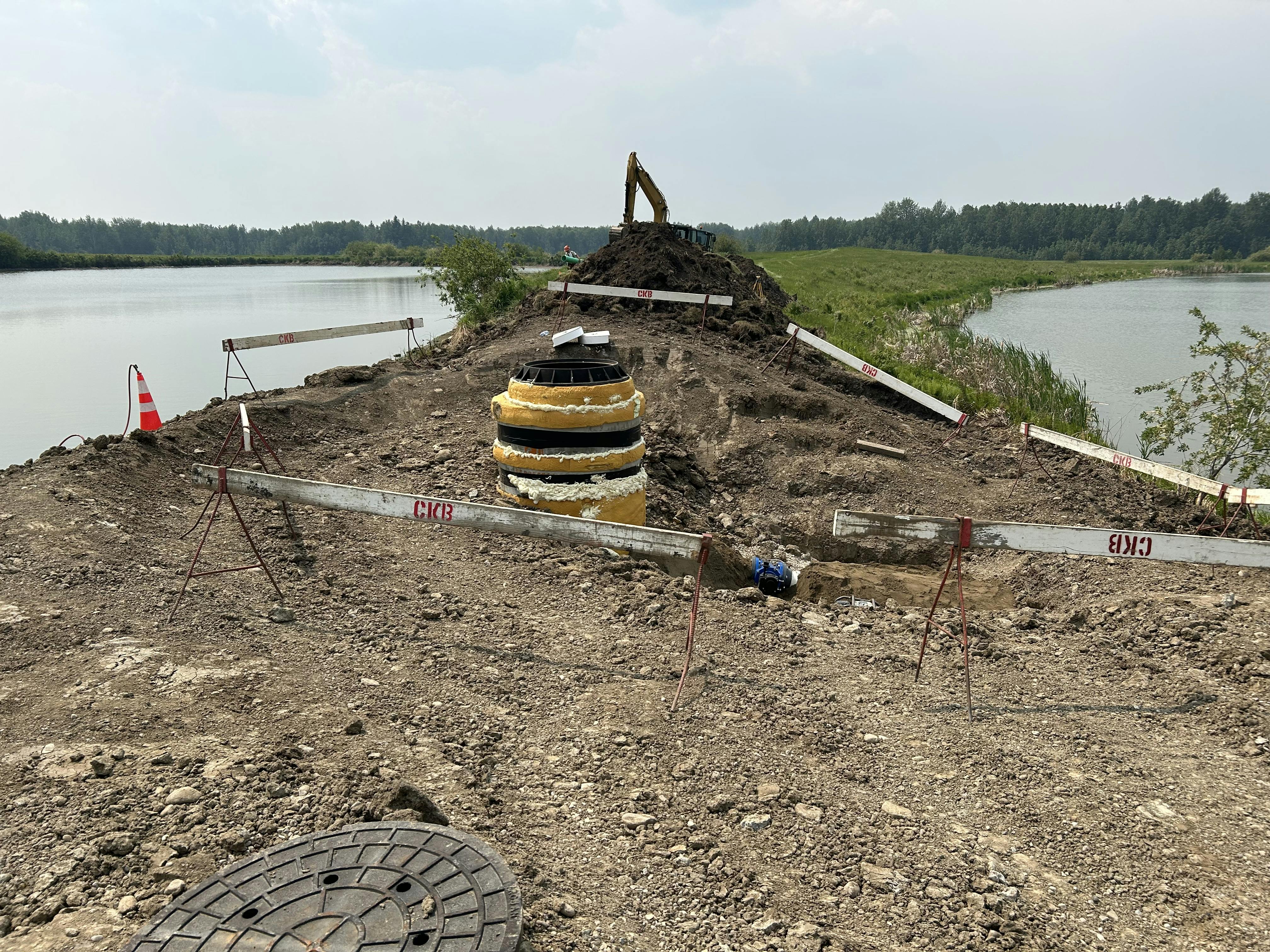

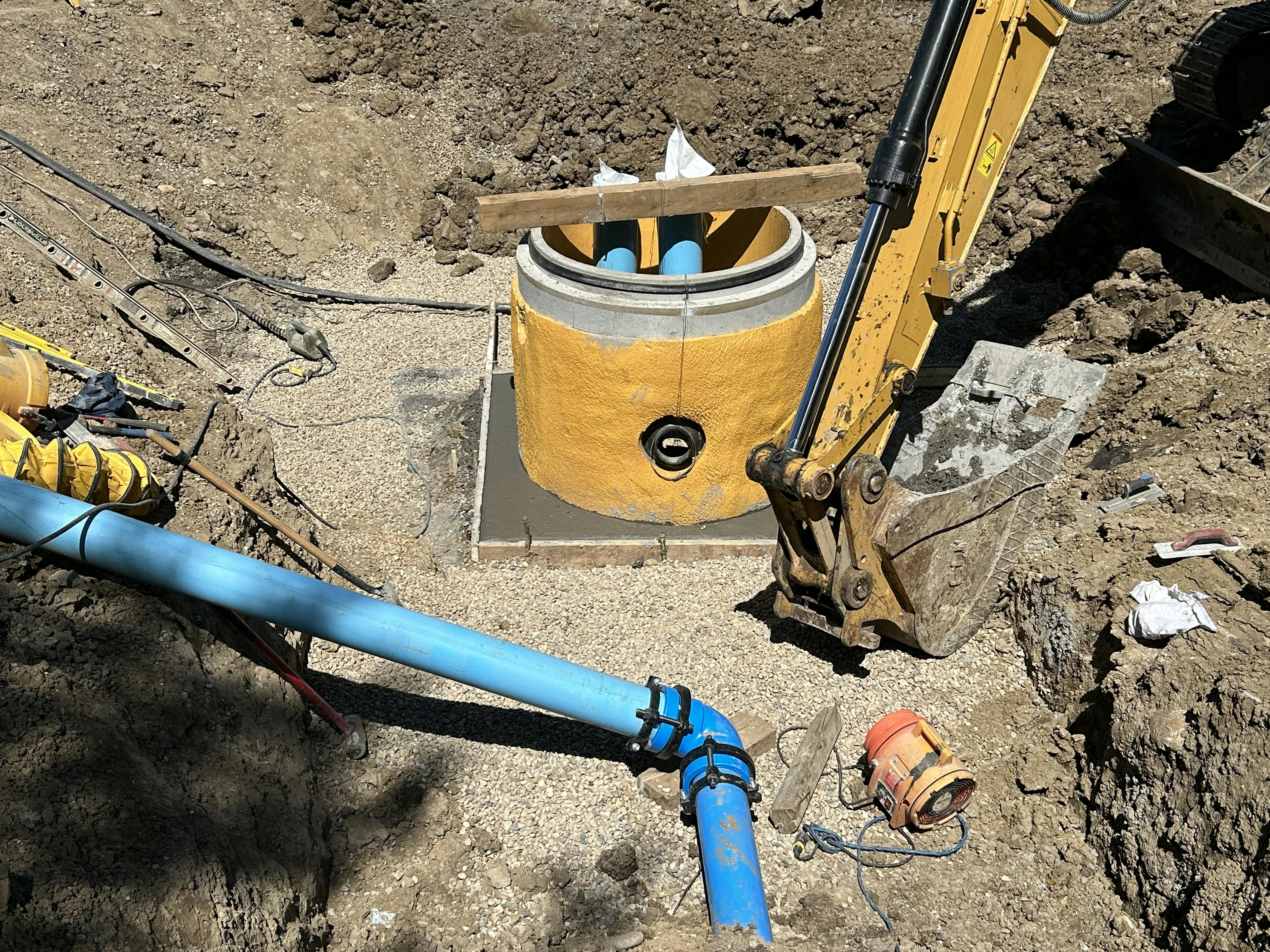

June 4, 2025 New Inlet structure installed and prepped for backfill. Control structure MH-097 removal completed, new control structure installed. Awaiting concrete for benching and thrust blocks prior to backfill.

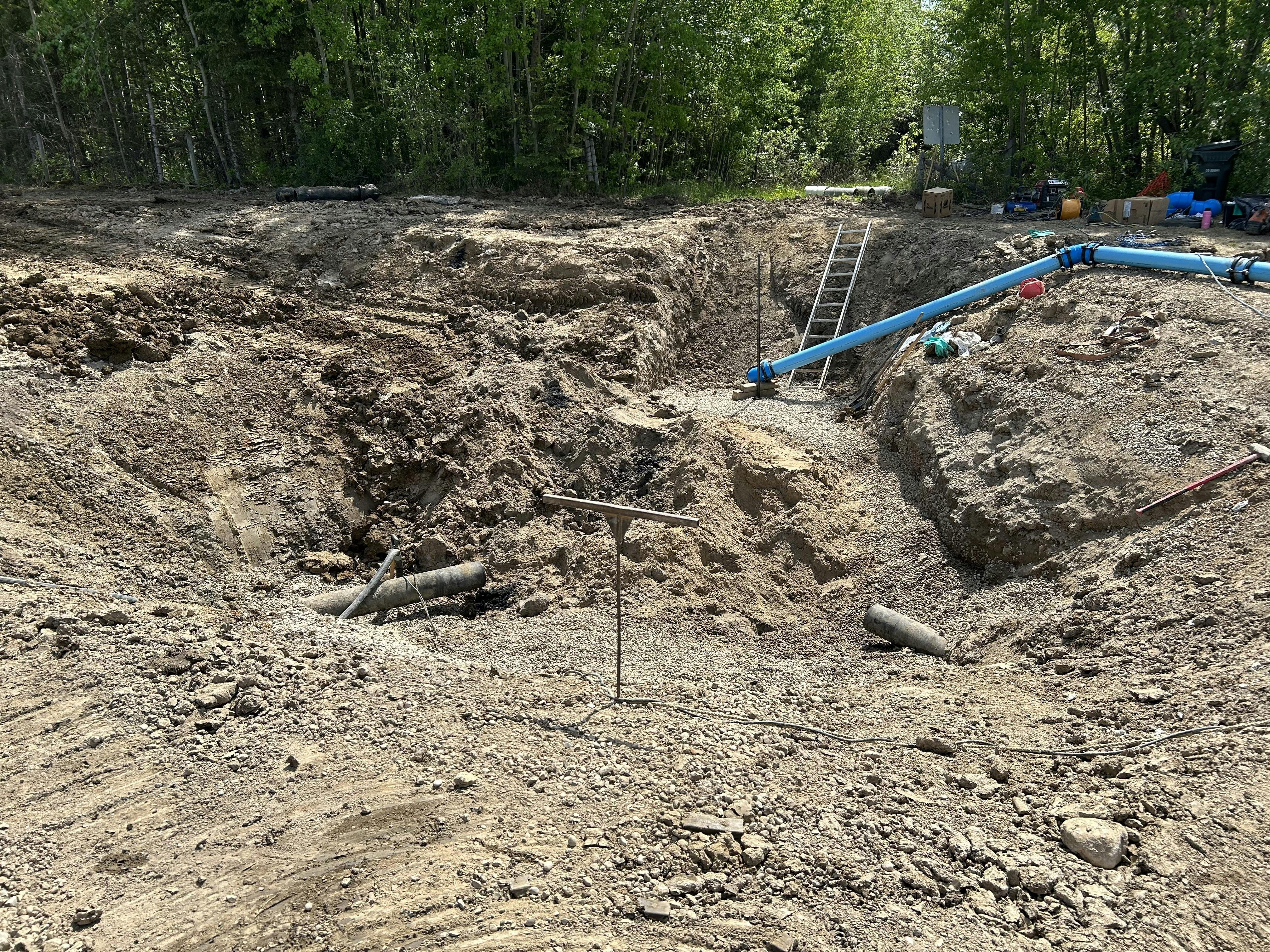

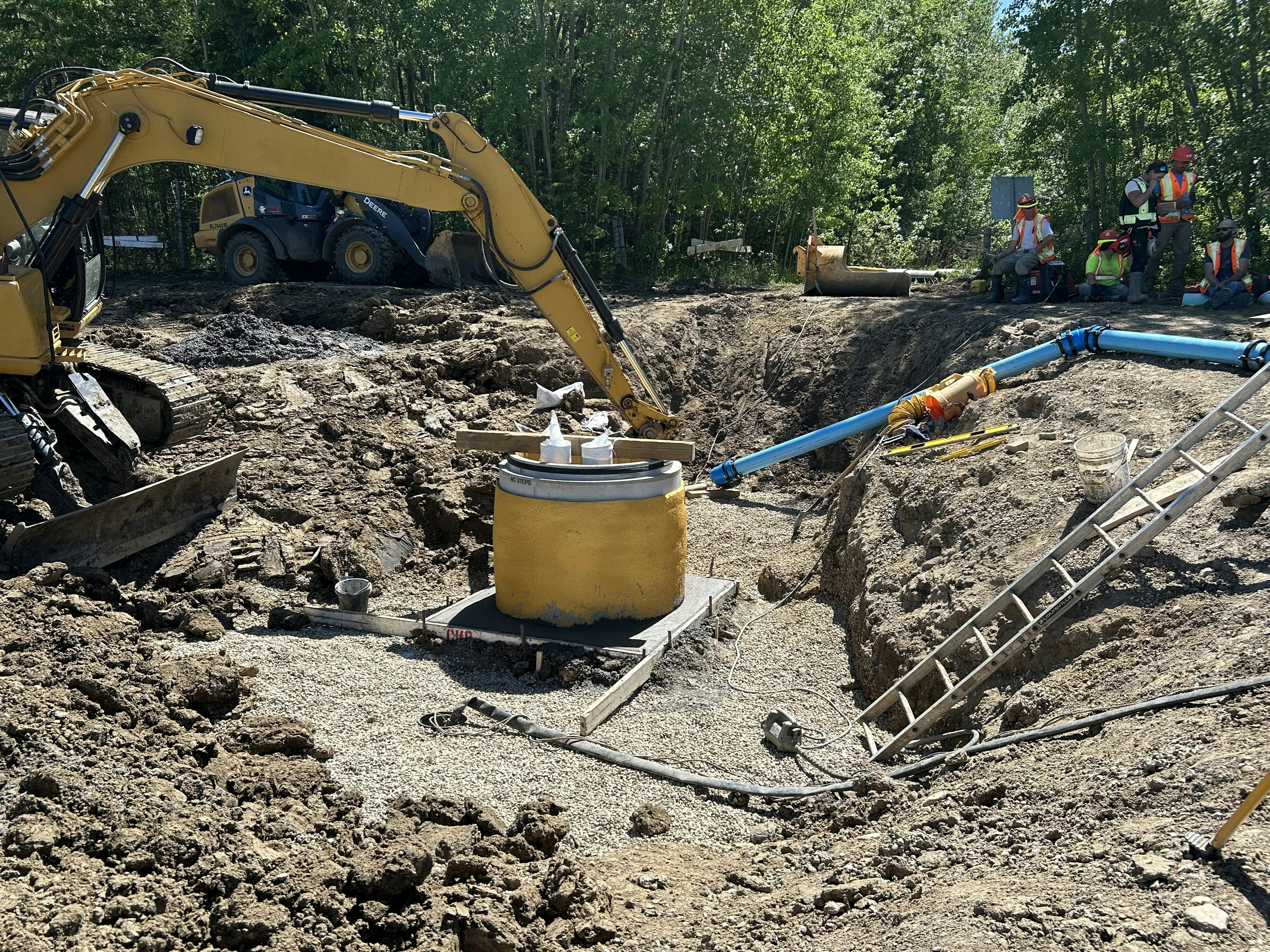

May 28, 2025 – Inlet structure has been removed, forcemain bypass to anaerobic cell installed. Rebar layout installed and prepped for concrete pour of new inlet base slab.


Location:

Wabamun Lagoon

Project Description:

Berm repairs and replacement of manholes and valves at the Wabamun Lagoon


Scope of Work:

Replacement of lagoon inlet manhole, control structure between facultative cell and storage cell A, and replacement of valves at Wabamun Lagoon. Berm repair was completed in 2024, only clean-up work remaining.


Schedule:

Est. Start date: May 21, 2025 – July 1, 2025

Schedule can change without notice, follow page for monthly updates.


Project Co-ordinator:

Contractor (Primary Contact): Jason Stiksma, CKB Construction, Jstiksma@ckbconstruction.com

Consultant (Secondary Contact): Greg Germain, ISL Engineering, ggermain@islengineering.com

Parkland Project Officer: Ryan McCaffrey, 780-217-9196, ryan.mccaffrey@parklandcounty.com


Updates:

October 1, 2025 – Project Complete. All deficiencies addressed and work will be monitored throughout the remainder of the warranty period.

June 18, 2025 – All construction and final walkthrough completed. Warranty now in effect until June 18, 2027.

June 4, 2025 New Inlet structure installed and prepped for backfill. Control structure MH-097 removal completed, new control structure installed. Awaiting concrete for benching and thrust blocks prior to backfill.

May 28, 2025 – Inlet structure has been removed, forcemain bypass to anaerobic cell installed. Rebar layout installed and prepped for concrete pour of new inlet base slab.


Location:

Wabamun Lagoon

Page last updated: 06 Oct 2025, 05:03 PM
