Acheson Zone 3 Wastewater Rehabilitation

Share Acheson Zone 3 Wastewater Rehabilitation on Facebook Share Acheson Zone 3 Wastewater Rehabilitation on Twitter Share Acheson Zone 3 Wastewater Rehabilitation on Linkedin Email Acheson Zone 3 Wastewater Rehabilitation link

Project Description:

Rehabilitation of Wastewater System in Acheson Zone 3 with the goal of reducing the amount of inflow (rainwater) and infiltration (groundwater) that enters the system to reduce the risk of system surcharging.


Scope of Work:

Full investigation of inflow and infiltration sources including inspections and vapour testing for leaks and cross connections. Primarily trenchless repair of manholes and mains in 2026-2028. Will be some open cut excavations where necessary. Construction will be prioritized in a phased approach over 3 years.


Schedule:

Est. Start date: May 2025 – Fall 2028

August 11-13, 2025: Dry weather pending, Vapour Testing to look for leaks and cross connections – affected properties will receive several notices prior to testing

April – May 2026: Continued prioritization and design. Specialized contractor pre-qualification process

Summer/Fall 2026: First Phase of Construction

2027-2028: Continued Phases of Construction

Schedule can change without notice, follow page for monthly updates.


Project Co-ordinator:

Contractor (Primary Contact): TBD in 2026

Consultant: (Secondary Contact): AECOM Canada, Jody Cherdarchuk, Jody.Cherdarchuk@aecom.com

Parkland Project Officer: Brandi Dechkoff, 780-968-8888 ext 8225, brandi.dechkoff@parklandcounty.com


Location:

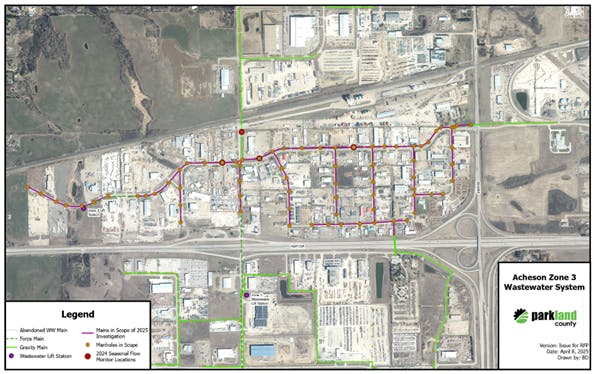

All of Acheson Zone 3 is being investigated; further updates of repair locations will be posted when design complete and budget approved.


Updates:

April 2026: Design continues and contractor pre-qualification for 3-year term initiated.

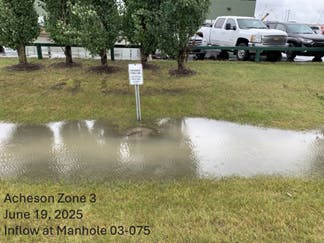

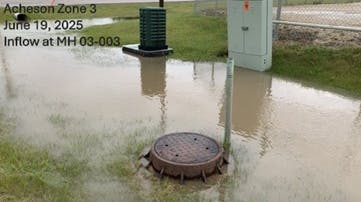

Fall 2025 – Winter 2026: Field assessments including CCTV of underground mains and manholes completed. Preliminary assessment and prioritization in process.

Aug 2025: Vapour testing – see attached notices

July 2025: Manhole inspections and flow monitors in the system

June 2025: Consultant Retained and Project Kick-off

Project Description:

Rehabilitation of Wastewater System in Acheson Zone 3 with the goal of reducing the amount of inflow (rainwater) and infiltration (groundwater) that enters the system to reduce the risk of system surcharging.


Scope of Work:

Full investigation of inflow and infiltration sources including inspections and vapour testing for leaks and cross connections. Primarily trenchless repair of manholes and mains in 2026-2028. Will be some open cut excavations where necessary. Construction will be prioritized in a phased approach over 3 years.


Schedule:

Est. Start date: May 2025 – Fall 2028

August 11-13, 2025: Dry weather pending, Vapour Testing to look for leaks and cross connections – affected properties will receive several notices prior to testing

April – May 2026: Continued prioritization and design. Specialized contractor pre-qualification process

Summer/Fall 2026: First Phase of Construction

2027-2028: Continued Phases of Construction

Schedule can change without notice, follow page for monthly updates.


Project Co-ordinator:

Contractor (Primary Contact): TBD in 2026

Consultant: (Secondary Contact): AECOM Canada, Jody Cherdarchuk, Jody.Cherdarchuk@aecom.com

Parkland Project Officer: Brandi Dechkoff, 780-968-8888 ext 8225, brandi.dechkoff@parklandcounty.com


Location:

All of Acheson Zone 3 is being investigated; further updates of repair locations will be posted when design complete and budget approved.


Updates:

April 2026: Design continues and contractor pre-qualification for 3-year term initiated.

Fall 2025 – Winter 2026: Field assessments including CCTV of underground mains and manholes completed. Preliminary assessment and prioritization in process.

Aug 2025: Vapour testing – see attached notices

July 2025: Manhole inspections and flow monitors in the system

June 2025: Consultant Retained and Project Kick-off
