Share Wabamun Building Product Site Reclamation on FacebookShare Wabamun Building Product Site Reclamation on X (formerly Twitter)Share Wabamun Building Product Site Reclamation on LinkedinEmail Wabamun Building Product Site Reclamation link
NOTE: This project has been completed, please see final update at the bottom of the page.
Project Description

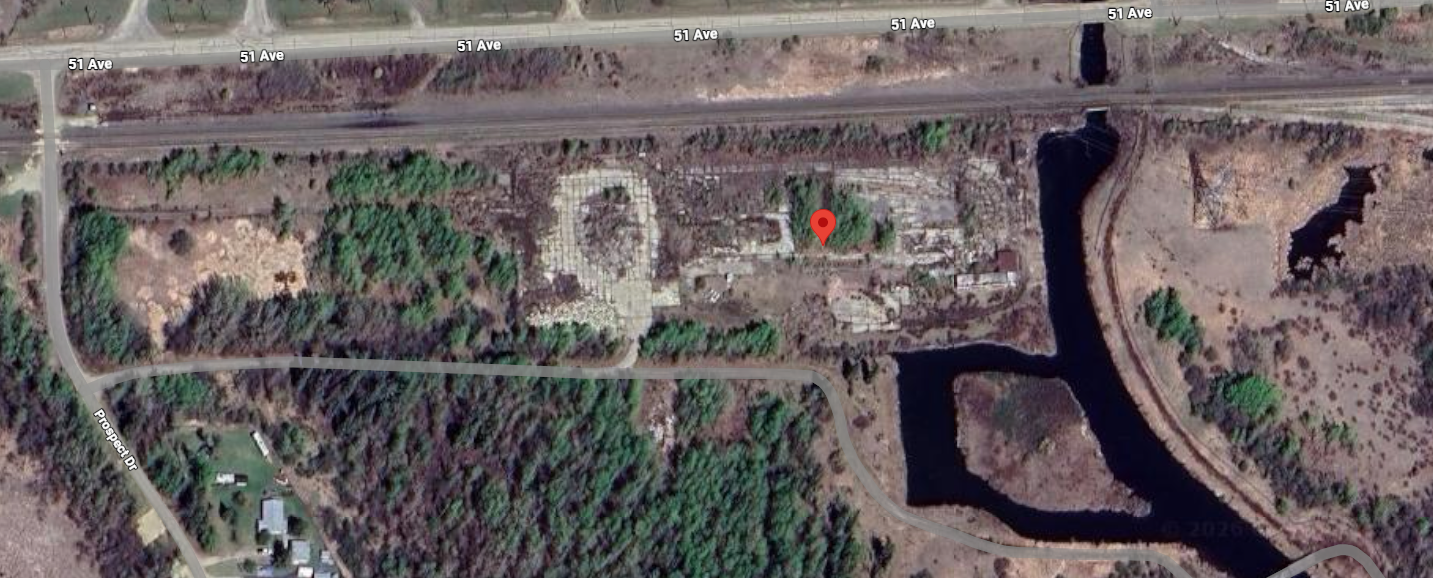

The area known as the Building Product Site (BPS) in Wabamun, located South of 51st Avenue and West of Prospect Drive, was used for industrial activities many years ago, before the County acquired the land. Testing has identified several small areas within the site where the soil is contaminated. However, the testing has not indicated any negative impacts from the contamination including any impacts to the lake.
As a precautionary measure, the County will remove the identified contaminated soils and dispose offsite. On the east side of the site, old concrete pads and the remains of former buildings are still present. These structures are deteriorating and are unsafe. As part of this project, the buildings and concrete slabs will be demolished to improve safety. The County is working in conjunction with an Environmental consultant and contractor to complete these scopes of work.
Scope of Work:
Remove and safely dispose of all identified contaminated soil at an approved off-site facility.
Complete follow-up environmental testing to confirm removal of identified contaminates.
Demolish all remaining buildings, slabs and concrete structures on East side of site.
Concrete rubble will be stockpiled on West side of the site on existing concrete slabs.
Rough grade the east portion of the site following remediation and demolition to improve site safety and conditions.
Remove all garbage from the site.
There is no in-water activity as part of this project.
Potential Impact to Residents:
There are no anticipated impacts to residents. Expect to see workers and trucks going to and from the site to load/unload equipment and materials. There are no expected Traffic Closures as a result of this project.
Schedule:
Estimated start date: January 26, 2026
Estimated completion date: March 2026
Please note that this schedule may change without notice.
NOTE: This project has been completed, please see final update at the bottom of the page.
Project Description
The area known as the Building Product Site (BPS) in Wabamun, located South of 51st Avenue and West of Prospect Drive, was used for industrial activities many years ago, before the County acquired the land. Testing has identified several small areas within the site where the soil is contaminated. However, the testing has not indicated any negative impacts from the contamination including any impacts to the lake.
As a precautionary measure, the County will remove the identified contaminated soils and dispose offsite. On the east side of the site, old concrete pads and the remains of former buildings are still present. These structures are deteriorating and are unsafe. As part of this project, the buildings and concrete slabs will be demolished to improve safety. The County is working in conjunction with an Environmental consultant and contractor to complete these scopes of work.
Scope of Work:
Remove and safely dispose of all identified contaminated soil at an approved off-site facility.
Complete follow-up environmental testing to confirm removal of identified contaminates.
Demolish all remaining buildings, slabs and concrete structures on East side of site.
Concrete rubble will be stockpiled on West side of the site on existing concrete slabs.
Rough grade the east portion of the site following remediation and demolition to improve site safety and conditions.
Remove all garbage from the site.
There is no in-water activity as part of this project.
Potential Impact to Residents:
There are no anticipated impacts to residents. Expect to see workers and trucks going to and from the site to load/unload equipment and materials. There are no expected Traffic Closures as a result of this project.
Schedule:
Estimated start date: January 26, 2026
Estimated completion date: March 2026
Please note that this schedule may change without notice.
Share Project Completion - April 2026 on FacebookShare Project Completion - April 2026 on X (formerly Twitter)Share Project Completion - April 2026 on LinkedinEmail Project Completion - April 2026 link
The Building Product Site inWabamunwas used for industrial activities before the County acquired the property. The site remained vacant for several years and was assessed through multiple environmental investigations, which identifiedsoilcontamination. The shallow contamination primarily consisted of metals; however, assessments confirmed that it had not migrated off-site and posed a negligible risk to human health and the environment.
In March 2026, the dilapidated building and other on-site infrastructure were demolished and transported to a nearby waste facility. A total of 664 tonnes of impactedsoilwere also removed and disposed of at an approved facility. Following remediation, the affected areas were recontoured to match the surrounding landscape and maintain natural drainage patterns. No further investigations were recommended by the environmental consultant.
In May 2026, the entire site was hydroseeded to encourage rapid vegetation establishment, which has been successful. The remaining stockpiled concrete will be used in future County projects to help reduce costs.
A site-based Remediation Certificate application was submitted to the Province and is currently under review.
The Building Product Site inWabamunwas used for industrial activities before the County acquired the property. The site remained vacant for several years and was assessed through multiple environmental investigations, which identifiedsoilcontamination. The shallow contamination primarily consisted of metals; however, assessments confirmed that it had not migrated off-site and posed a negligible risk to human health and the environment.
In March 2026, the dilapidated building and other on-site infrastructure were demolished and transported to a nearby waste facility. A total of 664 tonnes of impactedsoilwere also removed and disposed of at an approved facility. Following remediation, the affected areas were recontoured to match the surrounding landscape and maintain natural drainage patterns. No further investigations were recommended by the environmental consultant.
In May 2026, the entire site was hydroseeded to encourage rapid vegetation establishment, which has been successful. The remaining stockpiled concrete will be used in future County projects to help reduce costs.
A site-based Remediation Certificate application was submitted to the Province and is currently under review.
Mayor Rod Shaigec, Councillor Sally Kucher Johnson, Councillor Jason Doucette, Councillor Ben Jespersen, Councillor Corey Kyle, Councillor Kristine Olson, Councillor John McNab
